Power System Studies → Protection Coordination

Protection coordination study

When a fault happens, exactly one device should trip: the nearest one upstream. If a device further up operates first, a fault on one feeder takes out the whole plant. If the near device is too slow, a transformer or cable cooks before anything opens. A protection coordination study plots every protective device against every other one, finds where that order breaks, and gives you the settings that fix it.

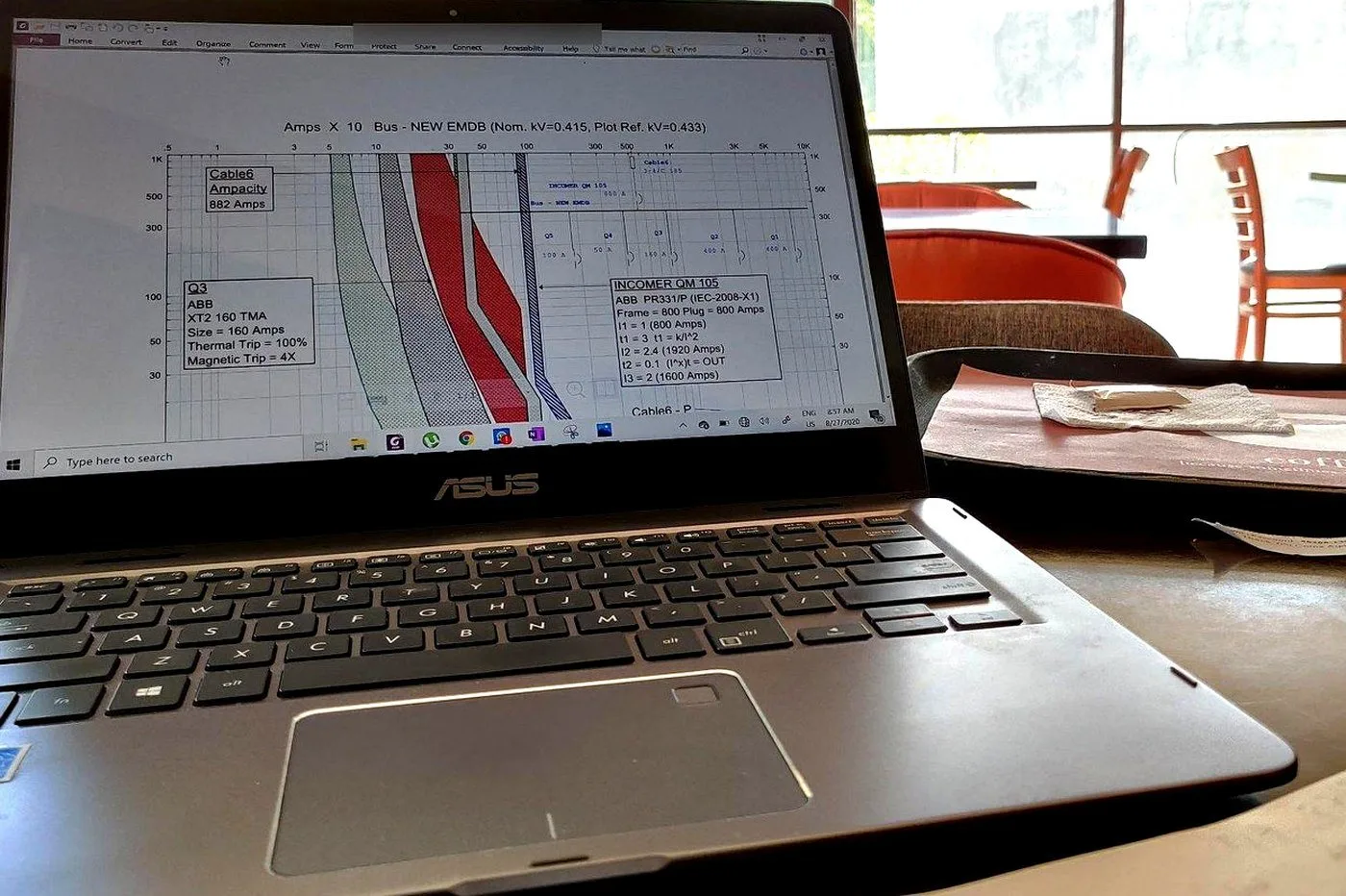

Protection coordination curves being graded on a laptop running ETAP
IEC 60255 and IEC 60909with IEEE 242 where a client asks for it
ETAP licensed since 2020running ETAP 24.0.3 · certificate on request
A settings schedule, not a PDFvalues your team can dial in
Delivered without a site visitbuilt from your data, anywhere

Miscoordination shows up in two ways, and only one of them is obvious

The one you notice

The wrong breaker trips

A fault on a single motor feeder opens the incomer instead, and the whole board goes dark. Production stops, the maintenance team resets whatever they can find, and nobody learns which device was actually at fault. It happens again three months later.

The one you don't

Nothing trips in time

A relay sits above a transformer's withstand curve over part of the fault range. For those currents the transformer takes more heat than its windings can survive while the relay is still counting. Nobody sees a symptom until the day it fails — and then it reads as end of life, not as a setting that was wrong for years.

Both are settings problems, not equipment problems. The devices are usually fine. What is wrong is the relationship between them — and that relationship only becomes visible when every curve is plotted on one sheet.

From real studies

What a coordination engineer sees

Two time–current plots exported from ETAP, with client details removed. Current runs left to right, tripping time bottom to top. For the system to be protected, each curve has to sit clear of the one it backs up — and below the damage curve of whatever it protects — across the whole range.

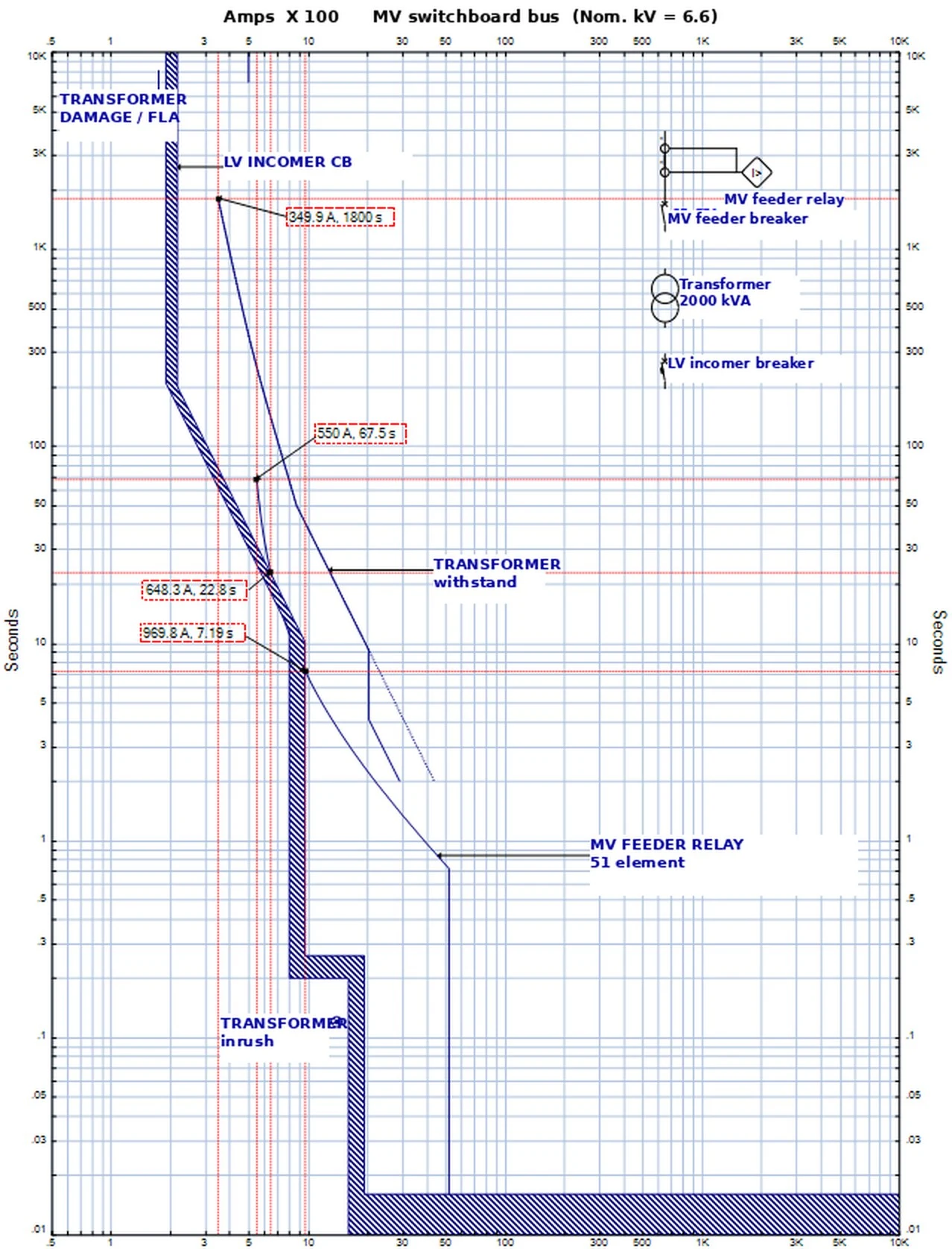

ETAP time–current curves for a 6.6 kV MV switchboard showing the MV feeder relay, transformer withstand and inrush curves and the LV incomer breaker, from an existing-settings evaluation
Before: curves that cross. Existing settings on a 6.6 kV board feeding a 2,000 kVA transformer. The marked points are where curves cross — over that range the devices do not operate in the order they should. Any new setting also has to stay right of the inrush point, or the plant trips every time it restarts.
ETAP time–current curves for an LV switchboard showing four breakers graded with clear margins
After: clean grading. Four breakers on an LV switchboard, each band clear of the one above it through the overload and short-time regions. A fault on a final circuit opens that circuit's breaker and nothing upstream moves.

On a recent study of a 22 kV cement plant stepping down to 6.6 kV and 415 V — INSEE's Thi Vai plant in Vietnam — eight device pairs failed to grade on the settings the plant had been running, including the one plotted above. All eight were corrected in the proposed schedule, with the sequence of operation re-simulated at every bus to prove the new order holds.

What the study covers

Coordination needs fault currents to grade against, so the short circuit analysis is inside the scope. Commissioned with an arc flash study, both run on one model.

Model build and verificationYour network built in ETAP from single-line diagrams, nameplate data, cable schedules and the utility fault level, then checked against the load flow so the model reflects how the plant actually runs.
Short circuit analysis to IEC 60909Three-phase and earth fault currents at every bus, with the making and breaking duty at each incomer checked against the device installed there. This is where undersized switchgear surfaces.
Evaluation of your existing settingsEvery device pair plotted as the plant runs today, with each non-grading pair named and the current range it fails over stated. You see the problem before you see the fix.
Proposed settings scheduleCurve type, pickup, time multiplier and instantaneous setting for every relay, and long, short and instantaneous settings for every LV trip unit — in per-unit and primary amps.
Equipment protection checksTransformer damage and inrush, cable withstand, motor starting duty and thermal limits, and generator stator damage where a set is installed — each plotted against the device meant to protect it.
Sequence of operationA fault applied at each bus in the simulation and the trip order recorded device by device, so the proposed settings are proven to grade rather than assumed to.

What you receive

DeliverableWhat it contains
Study reportExecutive summary, input data and assumptions, stated limitations, load flow, short circuit, coordination findings, sequence of operation and ranked recommendations — signed by a Chartered Electrical Engineer.
Settings scheduleOne row per protective element: CT ratio, curve, pickup in per-unit and primary amps, time multiplier, instantaneous pickup and delay — formatted to be worked through device by device during a shutdown.
TCC curve setExisting and proposed curves for every graded pair, annotated at the crossing points. The before set is what you show the board; the after set is what you keep on file.
Marked single-line diagramsThe modelled network with load flow, short circuit and device data on the drawing, as a working reference.
The ETAP modelAvailable on request. If you extend the plant next year, the next study starts from a verified model instead of from scratch.

What we need to start

Incomplete records are the norm. Send what you have.

  • Single-line diagrams, at whatever revision you hold
  • Transformer nameplates — rating, impedance, vector group, tap range
  • Protective device list: relay make and model, CT and VT ratios, and the settings currently applied
  • Circuit breaker ratings and trip unit types
  • Cable sizes, types and lengths for the main runs
  • Motor ratings for anything large enough to matter to the grading
  • The utility fault level at your incoming connection — your distributor will provide it on request

No site visit required. The study is built entirely from this data — no mobilisation, no travel cost, no disruption on your floor, and no reason a plant in Melbourne, Malé or Doha is harder to serve than one in Colombo. Where a record is missing we tell you exactly which value to read, and where on the equipment.

Four markets, four reasons it gets asked for

Sri Lanka

Plants grown feeder by feeder

Settings inherited from whoever commissioned each board over twenty years. The trigger is usually a nuisance trip that took the line down, or a group HSE audit from a multinational parent.

Maldives

Islands on their own generation

A protection failure is not an inconvenience but a dark island with guests on it. Grading across generator sets, changeover and distribution is the whole question.

Our Maldives work →
Australia

Commissioned with arc flash

Clearing time drives incident energy, so the two are solved together — with the arc flash side worked to ENA NENS 09 where your network operator requires it.

Vietnam and the Middle East

Industrial plants, delivered remotely

Cement, process and utility networks studied entirely from data — as at INSEE's Thi Vai plant in Vietnam — on the same terms and turnaround as Colombo.

Vibhawa engineer reviewing busbar protection grading on a laptop at a Maldives resort
Resort-side busbar grading, reviewed between site sessions in the Maldives.

A maintained ETAP seat since 2020

Licensed since 2020, currently on ETAP 24.0.3 — licence certificate available on request with any proposal. A maintained seat tracks the standard revisions and keeps its device library current, which is why the arc flash work alongside these studies is to IEEE 1584-2018.

The software is the cheapest part of a study. What takes the time is building a model from drawings that no longer match the plant, getting the fault level out of the utility, deciding which grading margin is defensible where the standard leaves room, and knowing which of the eight problems you found is the one that will cause an outage. The report carries a Chartered Electrical Engineer's signature — the part an insurer, an auditor or a parent company's HSE function is looking for.

What it is worked to

IEC 60255Measuring relays and protection equipment — the standard inverse, very inverse and extremely inverse characteristics the grading is built on.
IEC 60909Short circuit current calculation in three-phase AC systems, which sets the fault levels everything is graded against.
IEC 60947Low voltage switchgear and controlgear — the trip unit characteristics and breaker duties on the LV side.
IEEE 242 (Buff Book)Used where a client's own specification references the IEEE series rather than IEC.
4.9★★★★★
Average rating from our Google reviews — clients across Sri Lanka and the Maldives. Read them on Google →

Frequently asked

What is a protection coordination study?

An engineering study that plots the time–current characteristics of every relay, breaker and fuse in a network against each other and against the damage curves of the equipment they protect, so that the device nearest a fault always trips first. It produces a settings schedule for every protective device. It is also called a relay coordination study or protection grading study.

How long does it take?

Two to four weeks from complete data for a large industrial facility, depending on the size of the network. A single substation or a small resort island is faster. The clock starts when the data is complete, which is why we tell you early exactly what is missing.

Do you need to visit the site?

No. The study is built from drawings, nameplate data and your existing settings, which makes it practical to deliver to the Maldives, Australia, Vietnam or the Middle East at the same price as Colombo.

Can you apply the settings for us?

Applying settings is live work on your switchgear and belongs with the team that owns that equipment. The schedule is written to be worked through device by device during a shutdown, and we are available to your engineers while they do it. Where you want the relays tested afterwards, our protection system testing team can do it.

When should it be redone?

Whenever the network changes materially — a new transformer or feeder, a replaced relay, a generator added, or a change in the utility fault level at your incomer. Otherwise a five-year review is the usual cycle.

Do we need this if we are already doing an arc flash study?

It is already in it. Incident energy depends on how fast the upstream device clears, so the arc flash result is only as good as the coordination behind it. Commissioned together they share one model and one set of fault currents.

Send us the single-line diagram

That one drawing is usually enough to scope the study and quote it. If you also know your utility fault level, we can tell you on the first call whether there is likely to be a grading problem worth finding.
